Skip to content
Why your 20-off job gets the worst delivery date
Back to Journal
#USMTO machine tool orders#contract machine shops#CNC machining capacity#manufacturing technology investment#job shop automation#machining RFQ#reshaped-v3

Why your 20-off job gets the worst delivery date

Sadaf Masood

Your twenty-off job gets the worst delivery date because the capacity shops have been adding is not general capacity. It is automation sized for long unattended runs, and a job that cannot fill a pallet pool is the one that gets scheduled around everything that can. The fix is to stop shopping on rate and start shopping on date: put a required-on-dock date on the enquiry as a line the supplier has to answer, and place the work with whoever answers it.

The buying pattern is in the order data. Through the first seven months of 2026, US orders for metalworking machinery were up 37.1 per cent in value but only 13.0 per cent in units, and AMT attributes the gap to sustained growth in demand for additional automation. The average machine on an order costs about a fifth more than it did a year ago, and the difference is not spindle. It is the pallet changer, the robot loader and the probe bolted to the purchase order.

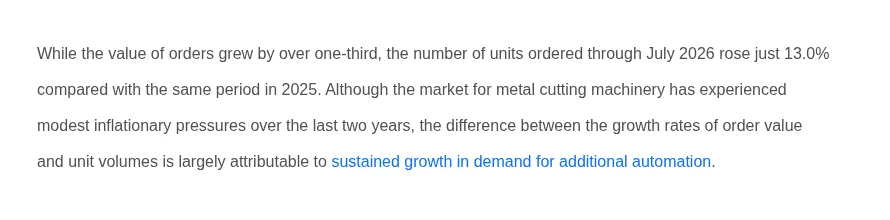

Paragraph from AMT's USMTO release stating that order value rose over one-third while units rose 13.0 per cent, attributed to demand for additional automation
From Manufacturing Technology Orders Exceed $500M for 5th Consecutive Month, AMT — The Association For Manufacturing Technology, 13 September 2026.

Look at what the machines actually are. Hurco's BM500U ships with a new eight-station pallet changer. Okuma's MULTUS U1000 comes with a thirteen-pallet tower. DN Solutions' AM2CNC pairs a five-axis machining centre with an automatic workpiece changer. Every one of those is bought to keep cutting while nobody is in the building, and the scheduling that goes with them is built to keep the pool loaded. A five-thousand-piece housing run loads the pool. Twenty gear housings, a broken shaft and ten enclosures for an inspection on Thursday do not, so they wait.

What to put on the enquiry so you get a date

Make the date answerable. Four things do most of the work:

  • The date you need it on your dock, stated as a requirement, not "ASAP". A shop that cannot hit it will tell you if the question is asked plainly, and that answer is worth more than a lower rate.
  • Quantity now, and whether it repeats. A dedicated fixture is only worth cutting if the part comes back. Say so, and the setup arithmetic changes in your favour on every order after the first.
  • Which tolerances actually matter. Two or three called out explicitly, with the datums they are measured from. Blanket tight tolerance across a drawing buys inspection time you did not need and pushes the date out.
  • Material: supplied or free-issued, with the grade and the certification you need on delivery. Waiting on bar is the most common reason a short job slips, and it is the one you can remove yourself.

When the automated shop is still the right one

For repeat volume it is the cheaper answer, and it is worth splitting your basket to use it. A part that runs five thousand at a time, with a stable drawing and no prospect of a change, belongs on a machine with a pallet pool: that is precisely the work the capital spend was justified against, and the unattended hours come off the piece price.

Keep the short work, the recoveries and the first articles somewhere that quotes them as jobs rather than as gaps between pallet loads. Those are different suppliers doing different things well, and asking one to be the other is how a Thursday deadline turns into the following month.

Have a part and a date? Send the drawing to Vesprr Workshop with the day you need it on your dock, and get both back on the quote.
